Abstract
Project management is the discipline of organizing and managing resources so that a project is completed within defined cost, quality, scope & time constraints. A project is a temporary and one-time undertaking to create a product or service which provides beneficial change or added value.
The responsible person to organize and to control a project is called project manager. There are some organizations which train necessary and useful project management skills. See, for example for PRINCE2 (external link!):
A detailed PRINCE2 © Training Manual, created on 03-May-2011, you can find at (external link!):
http://pmstudent.com/wp-content/uploads/The-PRINCE2-Training-Manual.pdf
Project Log Files
“The most successful people are those who are good at plan B.” [James Yorke]
Logfiles support a project manager at his day-to-day routine to coordinate and to control a project.
Daily Log
The daily log records activities or notable events that are not stored elsewhere.
Issue Log
The issue log records project problems and documents how they are tracked.
Valid entries are:
Lessons Learned Log
The lessons learned log stores good and bad experience with methods and products.
Valid entries are:
Quality Log
The quality log records checks and sign-offs of quality evaluations.
Valid entries are:

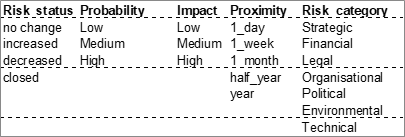

Risk Log
The risk log records and monitors identified project risks.
Valid entries are:
Please read my Disclaimer.
Project_Log_Files.xlsx [28 KB Excel file, open and use at your own risk]
Product Process Matrix
The PRINCE2 Product Process Matrix shows which project documents are created or updated in which project phase, and for which phase they provide inputs: (C = Create, I = Input, U = Update)
Project Brief | Project Initiation Document | Project Plan | Stage Plan | Business Case | Issue Log | Quality Log | Communication Plan | Risk Log | Configuration Item Record | |||
---|---|---|---|---|---|---|---|---|---|---|---|---|
Starting a Project | SU4 | Preparing a Project Brief | C | C | C | |||||||
SU5 | Defining Project Approach | I | I | |||||||||
SU6 | Planning an Initiation Stage | I | C | U | ||||||||
Initiating a Project | IP1 | Planning Quality | I | C | ||||||||
IP2 | Planning a Project | I | C | U | ||||||||
IP3 | Refining Business Case and Risks | I | U | U | U | |||||||
IP4 | Setting up Project Control | U | C | U | ||||||||
IP5 | Setting Up Project Files | I | C | |||||||||
IP6 | Assembling a Project Initiation Document | I | C | I | I | I | I | |||||
Directing a Project | DP1 | Authorising Initiation | I | I | I | |||||||
DP2 | Authorising a Project | I | I | |||||||||
DP3 | Autorising Stage and Exception Plan | I | I | I | I | I | ||||||
DP4 | Giving ad hoc Direction | U | I | |||||||||
DP5 | Confirming Project Closure | I | I | |||||||||
Controlling a Stage | CS1 | Authorising Work Package | U | U | U | U | U | |||||
CS2 | Assessing Progress | U | U | I | U | |||||||
CS3 | Capturing Project Issues | U | ||||||||||
CS4 | Examining Project Issues | I | I | I | U | U | ||||||
CS5 | Reviewing Stage Status | I | I | I | I | I | I | I | ||||
CS6 | Reporting Highlights | I | I | I | I | I | ||||||
CS7 | Taking Corrective Action | I | U | U | U | |||||||
CS8 | Escalating Project Issues | I | I | I | I | U | I | U | ||||
CS9 | Receiving Completed Work Packages | I | U | |||||||||
Managing Product Delivery | MP1 | Accepting a Work Package | U | U | ||||||||
MP2 | Executing a Work Package | U | ||||||||||
MP3 | Delivering a Work Package | I | ||||||||||
Managing Stage Boundaries | SB1 | Planning a Stage | I | I | C | I | U | U | ||||
SB2 | Updating a Project Plan | U | I | U | U | |||||||
SB3 | Updating a Project Business Case | I | U | U | U | |||||||
SB4 | Updating the Risk Log | U | I | U | U | |||||||
SB5 | Reporting Stage End | I | I | I | I | U | I | U | ||||
SB6 | Producing an Exception Plan | I | I | I | I | U | I | |||||
Closing a Project | CP1 | Decommissioning a Project | I | I | I | I | ||||||
CP2 | Identifying follow-on Actions | I | I | I | ||||||||
CP3 | Project Evaluation Review | I | U | I | I | I | I | I | ||||
Planning | PL1 | Designing a Plan | I | I | ||||||||
PL2 | Defining and Analysing Products | C | ||||||||||
PL3 | Identifying Activities and Dependencies | I | ||||||||||
PL4 | Estimating | |||||||||||
PL5 | Scheduling | |||||||||||
PL6 | Analysing Risks | U | ||||||||||
PL7 | Completing a Plan | C | C |
Please read my Disclaimer.
Prince2_Product_Process_Matrix.xlsx [16 KB Excel file, open and use at your own risk]
